Concrete Block Manufacturing Plant Setup Cost
Jun 16, 2026
Setting up a commercial concrete block manufacturing plant is not simply an expenditure on equipment procurement, but a systematic investment encompassing hardware facilities, civil engineering, and operational reserves. Based on the 2026 global building materials equipment market and practical experience in plant construction, the complete
concrete block manufacturing plant setup cost can be divided into four core segments. Each segment has a clear proportion and a defined fluctuation range, serving as the core basis for investors' budget planning.

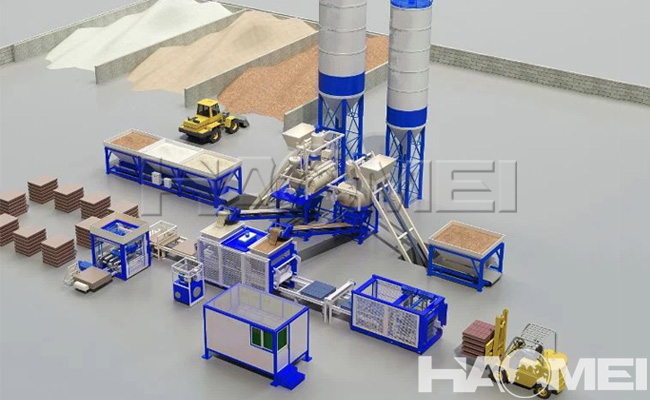

Core production equipment constitutes the largest component of the total investment cost, accounting for 50%–70% of the overall concrete block manufacturing plant setup cost. Taking the industry's mainstream export model as an example, the FOB price of the QT10-15 fully automatic block making machine is approximately US$36,000–75,000. If a complete production line is configured (including aggregate batching system, forced mixer, finished product conveying and automatic palletizing system), the total price range is US$80,000–180,000. The higher-capacity
QT12-15 block making machine, with a complete configuration, costs approximately US$120,000–250,000, and can meet the needs of large-scale production of over 20,000 blocks per day. In addition, customized molds, steel pallets, and other consumable components account for approximately 8%–12% of the total equipment investment and must be included in the initial equipment budget.
Site and civil engineering costs account for 10%–20% of the total investment and are the expenditure item with the largest regional variations. This part includes land leasing or purchase, hardening of production workshop floors, rainproofing of raw material storage yards, construction of finished product curing areas, and office support facilities. Taking a medium-sized standard factory area of 3,000 square meters as an example, the cost of site leveling, hardening, and basic factory construction in mainstream markets such as Southeast Asia and Africa is approximately US$30,000–80,000; the investment in infrastructure such as power transformers, water supply systems, and sewage facilities is approximately US$15,000–30,000. Land costs are greatly affected by the country and location, and are the core variable in the overall budget fluctuation. Most overseas projects prioritize leasing industrial land to reduce initial investment.
Installation, commissioning, and supporting auxiliary costs account for approximately 5%–10% of the total investment. The total cost for equipment shipping, destination port customs clearance, on-site installation and commissioning, and operator training is approximately US$15,000–40,000, with the exact amount varying depending on shipping distance and local customs policies. For material handling, auxiliary equipment such as forklifts and mini loaders can be purchased as needed, either new or used, with an investment of approximately US$20,000–60,000. Based on operational experience, it is recommended to allocate an additional 5% of the total equipment price as dedicated spare parts funds, stockpiling easily damaged hydraulic components, seals, etc., to ensure stable equipment operation during the initial production phase.
Initial operating working capital is also crucial, accounting for approximately 10%–15% of the total investment. The initial raw material inventory, including cement, sand, gravel, and admixtures, requires approximately US$10,000–30,000. Simultaneously, three months' worth of operating expenses such as personnel salaries, utilities, and administrative costs for business registration, production qualifications, and environmental filings should be reserved. Sufficient working capital can prevent cash flow interruptions due to payment cycles during the initial production phase and is a key guarantee for a smooth factory ramp-up.
In summary, the total setup cost for a medium-sized concrete block manufacturing plant (equipped with a QT10-15 production line, producing 10,000-15,000 standard hollow bricks per day) is approximately US$220,000-400,000; while a large-scale concrete block manufacturing plant (equipped with a QT12-15 production line, producing over 20,000 bricks per day) requires a total setup cost of approximately US$400,000-750,000. The final budget may fluctuate by 15%-20% depending on factors such as the level of automation, local infrastructure costs, and import tariff policies. Investors can choose the appropriate equipment based on local market demand, prioritizing the quality of core equipment and optimizing the allocation between civil engineering and working capital to effectively improve investment return efficiency.
